New HDB flats, Singapore

BTO renovation in Singapore, priced and permitted properly

BTO renovation is reported at S$51,000 to S$61,800 for a 4-room flat, inside an observed S$27,000 to S$145,000 spread. Every band here carries a date and a source, and you get the scope and the permit path before you commit.

The short answer

Fitting out a new HDB flat is reported at S$51,000 to S$61,800 for a 4-room, inside an observed range of S$27,000 to S$145,000. Only a firm in HDB’s Directory of Renovation Contractors may do the work, hacking needs written approval first, and every figure on this page is a dated range rather than a quote.

  1. 01 PERMIT

    Hacking always
    needs one

    All demolition and hacking of walls, partial or complete, needs HDB’s prior written approval before anything starts.

    hdb.gov.sg · read 2026-08-31

  2. 02 HOURS

    Mon to Fri
    9am to 5pm

    Restricted works only. General works such as painting and screed run Monday to Saturday until 6pm.

    hdb.gov.sg · read 2026-08-31

  3. 03 DEADLINE

    3 months for
    a new block

    From the date the permit is granted. Existing blocks get 1 month.

    hdb.gov.sg · read 2026-08-31

Scope

What a BTO renovation actually covers

A BTO flat before renovation, bare cement screed floor, untreated wall and a folding ruler
Illustrative image. This site publishes no photographs of completed projects, of anyone’s home, or of any team, and nothing here is a record of work we have carried out.

It is the first fit-out a new flat gets, in the window between key collection and moving in. Eight work packages, and naming them is the only way two quotes ever become comparable: hacking where HDB permits it, floor and wall finishes, kitchen, bathroom, carpentry, electrical, plumbing and painting, plus the permit paperwork filed before any of it can start.

A resale flat carries work this does not. Nothing here has to be stripped out first, and nothing has to be reinstated for a previous owner. That single difference is why the published bands for a new flat sit below the resale flat bands further down this page.

What it costs

Published cost by flat type, with sources and dates

The bands below are third-party datasets, each named and each carrying the date it was published. They are ranges, not quotes. Where two publishers disagree, both are shown rather than averaged into a number neither of them stands behind.

Reported cost by flat type n=3 bands · S$
Reported cost by flat type
Item Reported range
3-room BTO S$25k to 50k
4-room BTO S$51k to 62k
5-room BTO S$40k to 115k

Ranges as published by each source, not averaged together. Where two sources disagree, both are shown rather than reconciled.

Sources interiordiary.com.sg 2026-08-31qanvast.com 2026-08-31moneysmart.sg 2026-08-31

There is no 2-room row because no source we hold publishes one. The 2 room BTO renovation page gives the documented line items instead of inventing a total for it.

The rule

Who is legally allowed to renovate your HDB flat

Only a firm listed in the Housing & Development Board’s Directory of Renovation Contractors. That is not a marketing distinction, it is the Housing and Development (Renovation Control) Rules 2006, and it applies even to works that need no separate HDB approval at all.

Permit required

Only a contractor in HDB's Directory of Renovation Contractors may renovate an HDB flat

The requirement covers works that need no HDB approval as well, so it is not limited to hacking or structural changes.

hdb.gov.sg · read 2026-08-31
Verify it yourself

The penalty, and how to check a contractor yourself

Four stacked material samples on a pale bench: laminate, quartz offcut, tile and timber veneer, arranged in a row
Illustrative image. This site publishes no photographs of completed projects, of anyone’s home, or of any team, and nothing here is a record of work we have carried out.

Contravening the rules carries a fine of up to S$5,000 on conviction plus other penalties, and it attaches to the flat owner as well as to the contractor. That is the part most people miss: it is your liability too.

The check takes under a minute. Search the firm’s name in the Directory of Renovation Contractors e-Service before you pay a deposit, rather than after a dispute.

Not allowed

The penalty attaches to the flat owner, not only to the contractor

S$5,000

Contravening the Housing and Development (Renovation Control) Rules 2006 carries a fine of up to this amount on conviction, plus other penalties.

hdb.gov.sg · read 2026-08-31

A registration number proves only that the firm may lawfully do the work. It is not a quality mark, HDB does not rank anybody, and no firm is HDB approved whatever its website says.

Structure

What HDB lets you hack, and what it never will

A bare concrete structural wall beside a lighter non-structural partition, the junction between them visible
Illustrative image. This site publishes no photographs of completed projects, of anyone’s home, or of any team, and nothing here is a record of work we have carried out.

Structural walls, beams and columns are never removable. No budget, no drawing and no contractor changes that. Non-structural walls can go, but only with written approval obtained before work starts rather than applied for afterwards.

Permit required

Demolition and hacking need written HDB approval before work starts

Structural walls, beams and columns are never removable, whatever the layout drawing shows.

hdb.gov.sg · read 2026-08-31
Hours

Permitted working hours: general works versus restricted works

There are two classes of work and they have different windows. General renovation works such as plastering, painting and laying floor screed run Monday to Saturday, 9am to 6pm, and never on Sundays or public holidays. Restricted renovation works, which means demolition, removing wall or floor finishes and cutting tiles, run Monday to Friday, 9am to 5pm only.

Permitted renovation hours, as HDB publishes them

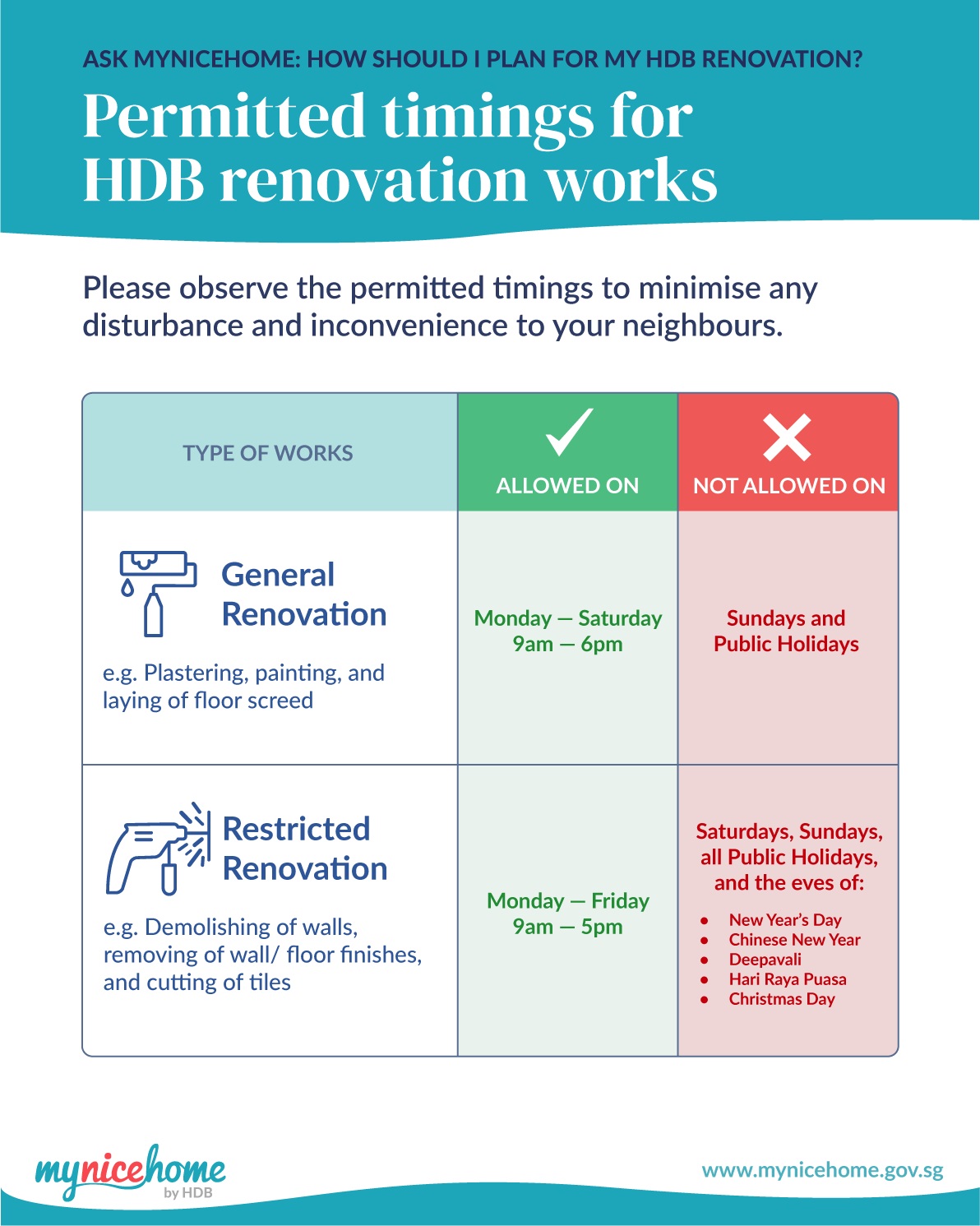

Permitted hours for general and restricted HDB renovation works General renovation works run Monday to Saturday 9am to 6pm. Restricted works, meaning demolition, removing wall or floor finishes and cutting tiles, run Monday to Friday 9am to 5pm only, and are also barred on public holidays and five named festival eves. MonTueWedThuFriSatSun GENERAL WORKS 9am to 6pm RESTRICTED WORKS 9am to 5pm Restricted works are also barred on every public holiday and on the eves of New Year’s Day, Chinese New Year, Deepavali, Hari Raya Puasa and Christmas. Restricted works: demolition, removing wall or floor finishes, cutting tiles.
Two different clocks. Most pages on this topic state only one of them.

Sources MyNiceHome by HDB 2026-08-31

This matters more than it looks. The AI answer currently served for this question states a single weekday window with no Saturday work, which describes the restricted class and gets the general class wrong. The figure above is reproduced from HDB’s own source graphic, read on 2026-08-31.

The exception

The five festival eves when restricted works are banned

A steel measuring tape, a spirit level and a folded flat plan lying on a bare windowsill
Illustrative image. This site publishes no photographs of completed projects, of anyone’s home, or of any team, and nothing here is a record of work we have carried out.

On top of Saturdays, Sundays and public holidays, restricted works are banned on five named festival eves: New Year’s Day, Chinese New Year, Deepavali, Hari Raya Puasa and Christmas Day.

Not allowed

Restricted works are banned on five named festival eves

The eves of New Year’s Day, Chinese New Year, Deepavali, Hari Raya Puasa and Christmas Day, in addition to Saturdays, Sundays and public holidays.

hdb.gov.sg · read 2026-08-31
The clock

Permit windows: three months in a new block, one in an existing one

Approved works must finish within three months in a newly completed block and one month in an existing one, counted from the date the permit is granted rather than the date anyone turns up. Neighbours within two units get written notice at least five days before works begin, and the Notice of Renovation stays displayed outside the flat throughout.

Does this work need an HDB permit?

Decision path for whether HDB renovation work needs a permit Four questions in sequence. Any yes means a permit is required before work starts. Only a no to all four means no permit is needed, and the guidelines still apply. Does it touch a wall? Yes, permit No, next question Does it touch wet areas? Yes, permit No, next question Does it touch the floor screed? Yes, permit No, next question Does it change the building envelope? Yes, permit No, none needed Works needing no permit still follow the guidelines and the permitted hours.
The dividing line is not how big the job looks. It is whether the work touches structure, wet areas, the floor screed or the building envelope.

Sources HDB 2026-08-31HDB building works 2026-08-31

New against resale

Why a BTO fit-out costs less than the same flat as a resale

A resale flat has to be stripped before it can be built. Someone else’s floor, someone else’s carpentry and someone else’s bathroom all come out first, and reinstatement is real, priced work. A new flat starts from a finished shell instead.

The gap narrows the moment you opt out of the Optional Component Scheme, because then the new flat also has a floor that has to be removed and made good before the one you want goes down. That is the section below, and it is the line most comparisons leave out.

Get a free quote

Tell us the flat type and when you collect keys. You get a scope discussion and an indicative cost band within one working day.

The scheme

The Optional Component Scheme decision

A clear morning window in an empty flat with a single potted plant on the sill and bare walls beyond
Illustrative image. This site publishes no photographs of completed projects, of anyone’s home, or of any team, and nothing here is a record of work we have carried out.

The Optional Component Scheme lets you buy flooring and sanitary fittings pre-installed by HDB at a fixed price folded into the flat price. The exact component list and the price are set per BTO launch rather than fixed across the scheme, so any figure you read belongs to that project and that year.

No permit needed

OCS pricing is set per BTO project, not fixed across the scheme

Opt in for a finished floor at a known price. Opt out and you pay to remove what is already there before paying for what you want.

hdb.gov.sg · read 2026-08-31
The line nobody quotes

What opting out really costs once hacking and making good are counted

Two documented projects report the same shape. One paid S$1,350 for two wall hackings with about S$650 to make good the cut surfaces, a total near S$2,400.

Making good is not optional tidying. A cut edge is jagged, and somebody has to re-plaster and re-finish it before anything else can happen in that room.

By flat type

Scope by flat type: 2, 3, 4 and 5-room

What changes between flat types is run length, not the work packages. A 4-room BTO flat has the longest carpentry run of the common types and the widest published cost spread, which is a scope signal rather than a market one. A 5-room adds corridor length that is dead area unless the carpentry plan reclaims it.

  1. Scope and measure

    We walk the flat after key collection, measure every run, and write down what you want changed and what HDB will let you change.

    No charge Utilities account with SP Services must be open first

  2. Permit and drawings

    Your contractor files the electronic application. Wall demolition needs the flat’s floor plan submitted with it.

    HDB charges nothing for the permit itself Only a Directory of Renovation Contractors firm may file it

  3. Hacking and wet works

    Demolition, tiling and anything touching the bathroom happen first, inside the restricted-hours window.

    Making good the cut surfaces is a separate line Mon to Fri, 9am to 5pm only

  4. Carpentry and finish

    Kitchen and wardrobe carpentry is fabricated to a fixed specification, then installed, then painted.

    Usually the largest single line item Complete within 3 months of the permit on a new block

Order of work

The renovation sequence, trade by trade

A bare kitchen shell with capped water stubs and no cabinets fitted
Illustrative image. This site publishes no photographs of completed projects, of anyone’s home, or of any team, and nothing here is a record of work we have carried out.

Each stage blocks the next, and two of them are routinely run out of order. Carpentry gets ordered before the site measure, and painting gets scheduled before the defects walk. Both cost money to undo.

How the work runs

  1. Permit filed Your contractor files it before anything starts. The window runs from the day it is granted.
  2. Hacking Restricted works, so the tightest hours apply. Everything after this waits on it.
  3. Wet works Screed, tiling and waterproofing. The decisions here are the ones you cannot revisit cheaply.
  4. First fix Electrical and plumbing points go in before anything is closed up.
  5. Carpentry Fabricated off site to the measured flat, then installed. Ordering before the measure is the classic mistake.
  6. Painting and handover Last, then a defects walk with the list written down rather than described.
Duration

How long a BTO fit-out takes

An empty flat at midday with hard window light crossing bare screed
Illustrative image. This site publishes no photographs of completed projects, of anyone’s home, or of any team, and nothing here is a record of work we have carried out.

The honest answer is that the permit window is the outside date, not the estimate. Three months in a new block is what the law allows, and a schedule that plans to use all of it has no room for the site conditions that appear once a wall is open.

Ask any contractor for lead time and install time as two separate numbers. Carpentry is fabricated off site, so the weeks before anything appears in the flat are real weeks, and a schedule that conflates them will slip.

The biggest line

Carpentry: the largest single line item

Carpentry is normally the largest single line, and it is priced per foot run. Run length drives the number far more than the headline rate does, which is why two quotes with the same rate can differ by thousands.

The variable nobody shows you is the carcass behind the finish. Plywood, moisture-resistant plywood, blockboard and MDF all take the same laminate and look identical on the day they are installed.

  • Plywood holds screws well and is the usual baseline.
  • Moisture-resistant plywood is the one that matters under a sink or in a bathroom vanity.
  • Blockboard is lighter and cheaper, and it is not a wet-area material.
  • MDF takes a finish beautifully and swells once water reaches it.

They do not look identical in year three, which is where a cheaper rate turns into the more expensive decision. Ask what the carcass is, and get the answer in writing.

Wet areas

Kitchen and bathroom: where budgets break

These two rooms carry the irreversible decisions. Waterproofing sits under the screed, and breaking the membrane changes the whole basis of a bathroom job rather than adding a line to it. Moving a plumbing point costs more than the cabinet it serves.

New flats also carry a three-year restriction on bathroom floor finishes, so the room you most want to change is the room with the least freedom in the first years. Plan around it rather than discovering it after the tiles are chosen.

What the surfaces and structure actually look like

  • An empty new apartment living room with bare cement screed floor and untreated wall, a folding ruler

    Bare screed and untreated wall at handoverGenerated illustration

  • Four stacked material samples on a pale bench: laminate, quartz offcut, tile and timber veneer

    Laminate, quartz, tile and timber veneer

  • A bare concrete structural wall beside a lighter non-structural partition, the junction between them visible

    Structural wall beside a non-structural partition

  • A steel measuring tape, a spirit level and a folded flat plan lying on a bare windowsill

    Tape, level and the flat plan: the site measure

Generated illustrations. Nothing on this site is a photograph of work performed by us.

Who may do it

Electrical and plumbing: who is allowed to do the work

Electrical work must be done by a worker holding the relevant Energy Market Authority licence, which is separate from the contractor’s own registration. Points and relocations are decided before first fix, because after that the walls are closed.

Permit required

Electrical work must be carried out by a worker holding an Energy Market Authority licence

The licence is issued by the Energy Market Authority and is separate from a renovation contractor's DRC registration.

hdb.gov.sg · read 2026-08-31
Comparing

What a quote must itemise before it is comparable

Four things, and a quote missing any of them cannot be compared to another quote.

What has to be on the page

  • Scope per room What is being changed, room by room, rather than a single line for the flat.
  • Materials by name The actual product, not an adjective. "Quality laminate" is not a specification.
  • Carpentry by foot run With the carcass material stated, because that is what the rate is hiding.
  • Provisional sums labelled Called out as provisional, with the rate that applies when they are resolved.

Without all four you are comparing two documents that describe different jobs, and the cheaper one is usually just the one that left more out.

And a quote produced without a site measure is a guess. An interior design firm and a direct contractor both have to measure the flat before a number means anything, whichever route you take. If nobody has been to the flat, the number is a brochure.

Get a free quote

Tell us the flat type and when you collect keys. You get a scope discussion and an indicative cost band within one working day.

Money

Payment milestones, and the one worth holding

Tie every payment to a stage you can stand in and look at, never to a calendar date. The last one matters most.

What each payment should be tied to

  1. Deposit on signing Tied to the contract, not to any work yet done.
  2. After hacking and wet works A stage you can stand in and see. Tie money to that, never to a date.
  3. After carpentry installation Measured, delivered and fitted, with doors and drawers actually operating.
  4. Final balance The only leverage you have once the work is substantially done and the defects list is being argued over.
Funding

Renovation loans: what they cover and what they do not

A renovation loan is how most people fund this, and the thing to notice is the shape of the spend. The money lands inside a short permit window, so financing spread over a year does not match what actually happens.

This site names no bank and recommends no lender. Size the borrowing against an itemised quote and a named contingency rather than against a headline package price, and read how an HDB renovation loan actually works before signing anything.

Avoidable

The mistakes that cost the most

In short

The four expensive mistakes are the same on every flat: starting before the permit, skipping the itemised quote, deciding finishes late, and treating the works window as the contractor’s problem rather than yours.

  • Every number: the publisher that printed it, and the date we read it.
  • Every rule: the HDB page it came from, linked.

Ordering carpentry before the site measure. Treating the permit window as the contractor’s problem rather than the constraint the whole schedule hangs on. Paying the final balance before the defects list is closed.

The expensive ones are all decisions made early and discovered late. That is why this site publishes the sequence and the rules before it publishes anything about design.

Method

How every figure on this site is sourced and dated

In short

Every figure on this site carries the source it came from and the day it was read. Regulatory claims cite HDB directly, and nothing is written from memory.

  • Every number: the publisher that printed it, and the date we read it.
  • Every rule: the HDB page it came from, linked.

Every number here carries a named publisher and the date it was read. Regulatory claims cite HDB directly. Where two sources disagree, both appear with their dates, because an average of two dated ranges is a figure nobody published and nobody will stand behind.

Cost figures come from Qanvast, MoneySmart and InteriorDiary, each with its publication date beside it, and MyNiceHome and HDB carry the rules. How we source and check our figures sets out the whole method.

Honesty

What we do not claim

No licence number, no accreditation badge, no review, no star rating and no photograph captioned as our own completed project. None of those exist for this site, so none of them appears on it. The interiors you see are generated illustrations and every one says so.

These are the checks we are telling you to run on any contractor, and that includes us. Ask for the registration, look it up yourself, and read the quote for the four things listed above.

Next

What happens after you send the form

Tell us which BTO project, which flat type and when you collect keys. We reply within one working day with a scope discussion and an indicative cost band, not a price for a flat nobody has measured.

Cited expertise

What making good actually costs, from someone who paid for it

Questions people ask before starting

How much does a BTO renovation cost in Singapore?

Reported bands run S$25,000 to S$50,000 for a 3-room flat and S$30,000 to S$65,000 for a 4-room (InteriorDiary, published 2025-11-07). A separate 4-room study reports S$51,000 to S$61,800 inside an observed S$27,000 to S$145,000 range (Qanvast, published 2025-10-10). Each is a dated figure from a named source, never a quote for your flat.

Do I need an HDB permit to renovate my BTO flat?

Yes for the works that need approval, and all demolition and hacking do. Your contractor files it before anything starts, and once granted you have 3 months to finish in a newly completed block.

Who is legally allowed to renovate an HDB flat?

Only a firm listed in HDB's Directory of Renovation Contractors, under the Housing and Development (Renovation Control) Rules 2006. That applies even to works that need no HDB approval.

What happens if the contractor is not HDB registered?

Contravening the Renovation Control Rules carries a fine of up to S$5,000 on conviction plus other penalties, and the liability attaches to the flat owner as well as the contractor.

What are the permitted renovation working hours?

General works such as plastering, painting and laying floor screed run Monday to Saturday, 9am to 6pm, and never on Sundays or public holidays. Restricted works such as demolition, removing finishes and cutting tiles run Monday to Friday, 9am to 5pm only.

Are there days when noisy work is banned outright?

Yes. Restricted works are banned on Saturdays, Sundays, all public holidays, and the eves of New Year’s Day, Chinese New Year, Deepavali, Hari Raya Puasa and Christmas Day.

How long do I have once the permit is granted?

Three months for a newly completed block and one month for an existing one, counted from the date the permit is granted rather than the date work starts.

Should I opt out of the Optional Component Scheme?

Opting in buys flooring and sanitary fittings at a price set per BTO launch and folded into the flat price. Opting out means paying to remove what is already there before paying to replace it, and making good the cut surfaces is a real cost that comparisons usually omit.

What must a renovation quote itemise?

Scope per room, materials by name, carpentry by foot run with the carcass material stated, and any provisional sums called out as provisional. A quote produced without a site measure is a guess, and it is not comparable to any other quote.

Which payment is worth holding to the end?

The final balance. It is the only leverage you have once the work is substantially done and the defects list is being argued over.

Can I renovate before I collect the keys?

No. The permit is tied to the flat and is applied for by your contractor, and works are counted from the date it is granted, which is after key collection.

Do you publish package prices?

No. This site publishes sourced, dated cost ranges as editorial content. A price for your flat only comes from a scope discussion after you send the form.

Why is the published range so wide?

Because the scope behind it varies more than the finishes do. A flat where nothing structural moves sits near the bottom of a range; one where walls move and carpentry runs through every room sits near the top. The range describes a set of finished projects, not a price for yours.

Do I need an HDB permit to renovate?

You need one for some works and not others. All demolition and hacking of walls, partial or complete, needs HDB\u2019s prior written approval before anything starts. Other works may proceed without a permit, but they still have to be carried out by a contractor in HDB\u2019s Directory of Renovation Contractors.

Sources

  1. Important Information on RenovationsHousing & Development Boardread 2026-08-31
  2. Permitted timings for HDB renovation worksMyNiceHome by HDBread 2026-08-31
  3. Renovation Guidelines for Building WorksHousing & Development Boardread 2026-08-31
  4. Renovation Guidelines for Electrical WorksHousing & Development Boardread 2026-08-31
  5. 4-Room BTO Flat Renovations in Singapore: From $27K to $145KQanvastread 2026-08-31
  6. HDB Renovation Cost & Loan Guide SingaporeMoneySmartread 2026-08-31
  7. BTO Renovation Singapore: Complete Cost, TimelineInteriorDiaryread 2026-08-31

Checked against primary sources · updated 2026-09-01

Get a free quoteThanks, we have your details. We reply within one working day with a scope discussion and an indicative cost band.
